BM101.PM
⏰Estimated Practice Time: 30 Minutes
Objective
Learn how to create a Project Task Tracker to organize tasks, track progress, and monitor deadlines using Excel’s beginner tools.
Scenario: Project Task Tracker
Set Up Your Project Task Table:
Open Excel and create the following headers in Row 1:
A1: "Task Name" | B1: "Assigned To" | C1: "Start Date" | D1: "End Date" | E1: "Status" | F1: "Days Remaining"
Format the headers:
Select A1:F1, click Bold, increase the font size to 12, and apply a light fill color (e.g., light gray).
Input Sample Task Data:

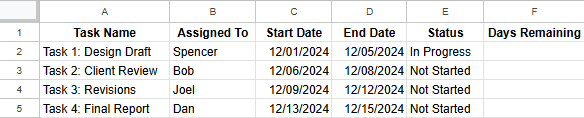

Starting in Row 2, enter the following sample project tasks:
Calculate "Days Remaining":
In cell F2, calculate the remaining days until the task's due date using this formula:
=D2-TODAY()
Press Enter.
Copy the formula down to cells F3:F5 by dragging the fill handle.
This will calculate the number of days left until the task’s End Date.
Format the Date Columns:
Highlight cells C2:D5.
Go to Home → Number Group → Short Date to ensure dates are formatted clearly.
Apply Conditional Formatting for Status:
Highlight the Status column (E2:E5) to make the project easier to read:
Go to Home → Conditional Formatting → Highlight Cell Rules → Text That Contains.
Apply the following rules:
"In Progress" → Light blue fill.
"Not Started" → Light yellow fill.
"Completed" → Light green fill.
AutoFit Columns for Clarity:
Double-click the column separators between A, B, C, D, E, and F to adjust the column widths.
